An AEC outsourcing contract defines how external teams deliver CAD, BIM, and construction documentation work. Many agreements fail because the scope is vague, digital deliverables are not controlled, and liability is unclear. That leads to rework, delays, and disputes. A strong AEC outsourcing service agreement solves this with a clear scope, measurable deliverables, structured service levels, and defined responsibilities. It also addresses BIM data, intellectual property, and risk allocation.
This guide explains how to structure an outsourced CAD drafting contract or BIM outsourcing agreement clauses so your projects stay on schedule, your data stays protected, and your team stays in control.
What is an AEC Outsourcing Contract?
An AEC outsourcing contract is a service agreement where a vendor provides defined AEC delivery support (CAD drafting, BIM modeling, coordination, estimating, documentation) under agreed scope, timelines, and review rules.
Difference Between Contract Types
It is important to separate different engagement models:
Employment contract
- Full-time internal hire
- Employer controls tools, time, and deliverables
Freelance agreement
- Individual contractor
- Limited structure and scalability
AEC outsourcing service agreement
- Structured vendor relationship
- Includes MSA, SOW, SLA, and NDA
- Designed for repeatable AEC production
Examples
Common use cases include:
- Hiring a virtual architect for production support
- Creating an outsourced CAD drafting contract for AutoCAD or Revit work
- Remote construction estimation or BIM coordination support
These engagements often involve deliverables such as:
- Revit models, AutoCAD sheets, Navisworks coordination files
- IFC exports, clash detection reports, markups, and redlines
Without a proper contract, these outputs create risk.
Why AEC Outsourcing Agreements Fail (and What Fixes It)
Most failures are not “bad vendors.” There are contract gaps. The fix is a measurable scope, clear digital rules, and defined responsibility boundaries.
The “Scope Gap” Problem
Scope gaps happen when the agreement says “drafting support” but does not define:
- which sheets/models
- which format/LOD
- which submission state (WIP vs Published)
- What “done” means
Example: “Update the Revit model” is vague. “Update LOD 300 architectural model + publish sheets A1.1–A2.4 + issue PDF + RVT + NWC export” is measurable.
Digital Deliverables Risk
AEC projects rely on digital files. That creates risk if not controlled.
Common issues include:
- Wrong file versions
- Missing version control
- Inconsistent naming
- Misuse of BIM models for unintended purposes
For example, A coordination model is used for fabrication without approval.
A strong BIM outsourcing agreement clause must define:
- File formats (RVT, DWG, IFC)
- Naming conventions
- Versioning rules
- Allowed use
This is where standards like AIA digital practice documents and ConsensusDocs BIM addenda help define expectations.
Hidden Liability
Liability is often misunderstood in AEC outsourcing.
Key questions:
- Who owns errors in drawings?
- Who pays for rework?
- Who carries professional responsibility?
Without clarity, disputes escalate.
An effective contract aligns:
- Indemnity obligations
- Limitation of liability
- Standard of care
The goal is not zero risk. It is a defined risk.
Before You Sign: Define the Outsourcing Model
You must lock the engagement model first. Everything else depends on it: pricing, direction, QA gates, and who manages day-to-day work.

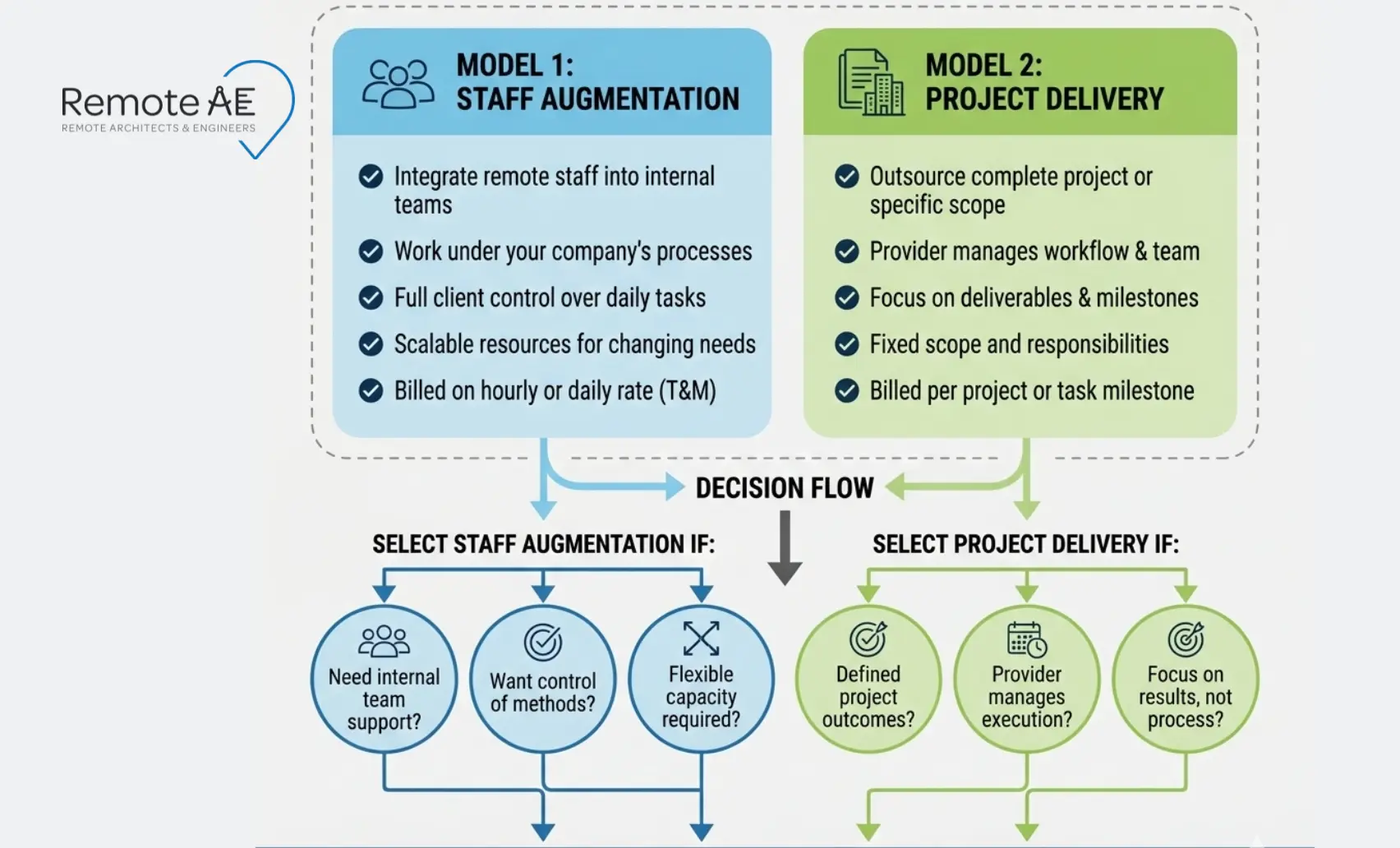

Staff Augmentation vs Project-Based Delivery
There are two primary models:
- Staff Augmentation
- External resource works within your team
- You control tasks and priorities
- Example: Remote Revit modeler
- Project-Based Delivery
- Vendor delivers a full package
- Vendor manages production
- Example: Complete DD or CD set
Each model requires different SOW and SLA definitions.
Who Directs the Work
State it clearly:
- If your PM directs work, the contract must specify response time, revision rules, and file access expectations.
- If a vendor PM directs work, the contract must specify escalation, reporting cadence, and how decisions are approved.
Example Scenario
Scenario A:
Remote Revit modeler as staff support
- Works inside your BIM Execution Plan
- Follows your templates and standards
- Your team reviews outputs
Scenario B:
Full DD set production
- Vendor produces drawings
- Vendor manages internal QA
- You approve final deliverables
These are completely different risk profiles. Your contract must reflect that.

The SOW That Prevents Rework
A strong SOW (Statement of Work) is the part of your AEC outsourcing contract that stops misunderstandings before they become rework. Rework is expensive, and poor project data plus miscommunication is a known driver: one report found 52% of rework was caused by poor project data and communication (FMI + PlanGrid, 2018).
Deliverables List
Specify outputs clearly.
Include:
- File formats (DWG, RVT, IFC, NWC)
- Drawing sets and sheets
- Model versions
- Markups and redlines
- Clash detection reports
Avoid generic descriptions.
Acceptance Criteria
Define what “done” means.
Examples:
- All sheets match the sheet index
- No unresolved clashes above threshold
- Annotation standards followed
- QA checklist completed
This protects both parties.
Revision Rules
Revisions are a major source of conflict.
Define:
- Number of included revision rounds
- What qualifies as a change
- What triggers a change order
Without this, scope creeps.
Example Deliverables Table
| Deliverable | Format | Standard |
| Architectural model | RVT | LOD 300 |
| Sheet set | PDF+DWG | Client template |
| Coordination export | NWC+IFC | Weekly issue |
| Issue log | Excel / CDE | Updated daily |
Service Levels (SLA) for AEC Work
A strong remote drafting service level agreement defines how work is delivered, not just what is delivered. Without clear service levels, even a good team can miss expectations.
Turnaround Time by Task Type
Different AEC tasks require different timelines. Your SLA should define the expected turnaround for each:
- Redlines → 24–48 hours
- Sheet updates → 2–3 days
- BIM coordination updates → weekly cycle
- Clash detection reports → scheduled milestones
This avoids the constant “when will this be done?” questions.
Response Time vs Resolution Time
Separate communication from execution.
- Response time → How fast the team acknowledges a request
- Resolution time → How long it takes to complete it
Example:
- Response within 4 hours
- Resolution within 48 hours
This keeps communication predictable.
Quality Metrics
Quality must be measurable. Include metrics such as:
- Clash rate per model (Navisworks reports)
- Annotation errors per sheet set
- Sheet index accuracy
- Compliance with templates and families
These align with BIM standards and improve consistency.
Remedies
Define what happens when targets are missed:
- Rework at no charge for vendor-caused errors
- Credits tied to missed SLA windows
- Escalation path (PM → vendor lead → executive sponsor)
BIM/CAD + Digital Data Terms You Should Not Skip
Most AEC outsourcing disputes are digital disputes: who used what file, which version was “latest,” and what the model was allowed to be used for.
Authorized Use of Digital Data
State permitted uses by deliverable type:
- Coordination
- Construction documents production
- Quantity takeoffs (if allowed)
- Fabrication (usually restricted unless explicitly allowed)
Model Exchange Rules
Your contract should define:
- File naming conventions
- Publishing schedule
- Version control process
- Central storage location
Use a Common Data Environment (CDE) for all project files. This ensures one source of truth.
BIM Execution Plan Alignment
Your outsourcing partner must follow your BIM Execution Plan (BEP).
This includes:
- Level of Development (LOD) targets
- Model structure
- Clash detection workflow
- Coordination rules
Standards such as AIA G203-2022 provide guidance for digital data protocols.
Central Document System + Access Rules
Define where files live.
Examples:
- Autodesk Construction Cloud
- BIM 360
- Internal CDE
Access should follow least privilege principles. Only required users get access to specific files.
Example Clause
“Models will be published weekly to the CDE. All revisions must follow naming conventions and version control procedures.”
IP Ownership, Licensing, and “Work Product” Language
Intellectual property is often overlooked in an outsourced CAD drafting contract. But it becomes critical when projects evolve.
IP Assignment vs License
In most AEC outsourcing, you usually need:
- ownership (or broad license) to use the deliverables for the project
- the right to reuse deliverables for facility lifecycle work (if that matters)
- clear limits on vendor reuse of your project information
Background IP
Vendors often use their own tools:
- Families
- Templates
- Scripts
These are background IP. Your contract should allow use without transferring ownership.
Tool Licensing
Clarify who provides software:
- Revit, AutoCAD, and Navisworks licenses
- Plugins and add-ons
- Fonts and templates
This avoids delays during onboarding.
Example Clause
“Ownership of deliverables transfers upon full payment. Vendor retains rights to proprietary tools and templates.”
This balances ownership and practicality.
Confidentiality, Privacy, and Security for Project Data
AEC project data includes sensitive client info, site addresses, and proprietary details. Treat it like a real security program, not a checkbox.
Stat for context: Verizon reports the “human element” is involved in breaches at around 60% (Verizon DBIR Executive Summary, 2025)
NDA Basics
A strong NDA should include:
- Definition of confidential information
- Permitted use
- Exclusions
- Duration
This protects client and project data.
Security Controls
Minimum expectations include:
- Multi-factor authentication (MFA)
- Role-based access control
- Device security policies
These align with guidance from NIST for data protection.
Incident Response
Define how security incidents are handled.
Include:
- Notification timelines
- Investigation process
- Resolution steps
Using NIST incident handling practices as a reference helps standardize this.
Subcontractors and Downstream Access
If the vendor uses subcontractors:
- They must follow the same rules
- Access must be controlled
- Approval must be required
This prevents uncontrolled data exposure.

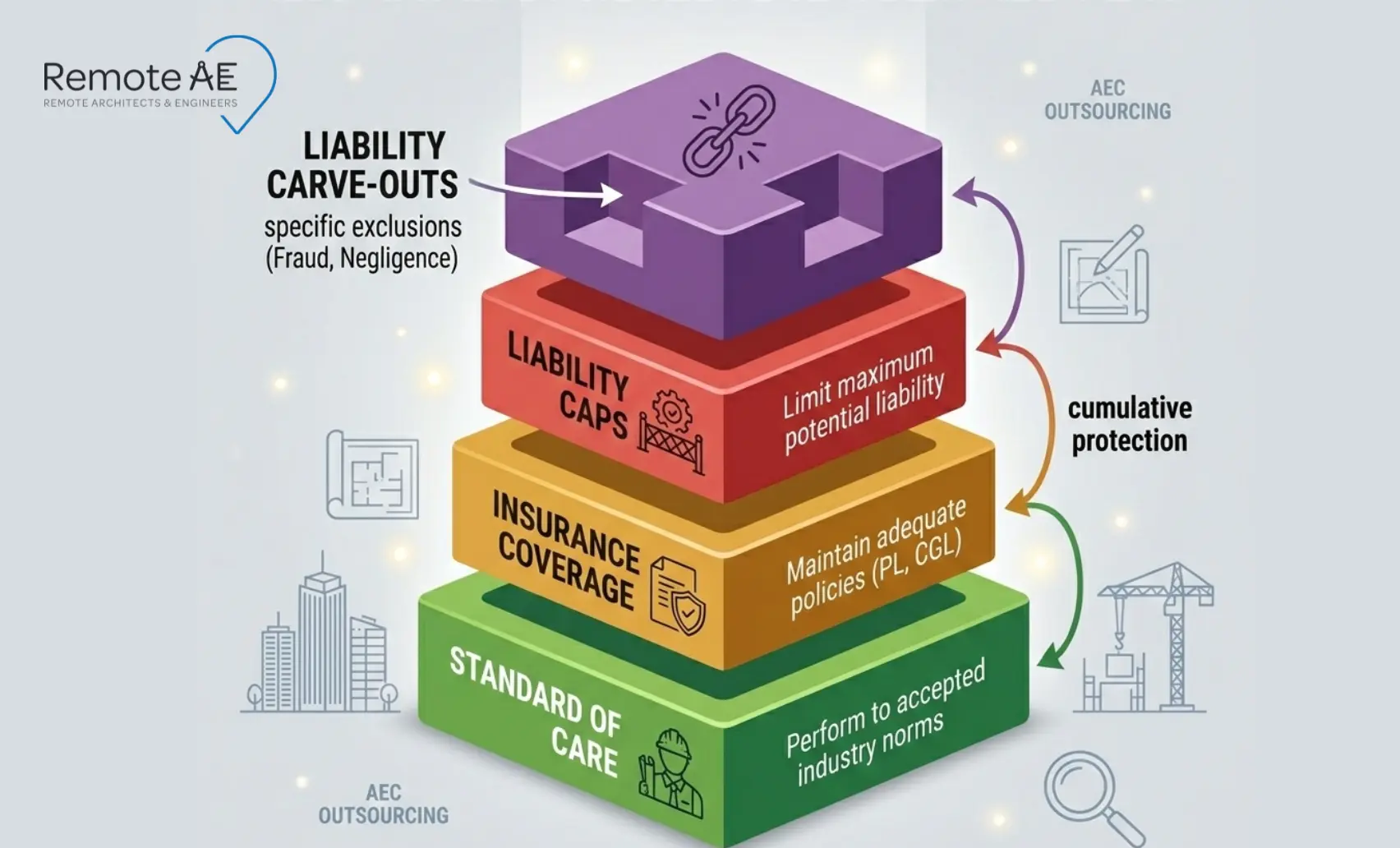

Liability, Indemnity, Insurance, and Caps
Risk allocation is one of the most important parts of an AEC outsourcing contract.
Indemnity vs Limitation of Liability
These two clauses work together:
- Indemnity → Who pays for specific claims
- Limitation of liability → Maximum financial exposure
Without limits, risk becomes unpredictable.
Cap Design
Typical caps include:
- Total fees paid
- A multiple of fees
Carve-outs may apply for:
- Confidentiality breaches
- IP violations
Insurance Proof
Require vendors to carry:
- Professional liability
- Cyber insurance
- General liability
This adds protection for both parties.
Standard of Care
Avoid language that implies perfection. Use a standard-of-care concept aligned to professional practice (“reasonable care consistent with similar professionals under similar circumstances”).

Compliance and Professional Responsibility
AEC outsourcing contracts must respect licensing and responsibility boundaries. Outsourcing can support production, but a licensed professional still owns responsibility for charge and stamping decisions.
Stamping and “Responsible Charge” Boundaries
Only a licensed Professional Engineer (PE) or registered architect can stamp drawings. Even when using outsourced CAD drafting or BIM support, the licensed professional retains responsible charge.
This means:
- Final decisions remain in-house
- Review and approval cannot be outsourced
- The license holder must verify stamped documents
Remote teams support production, not professional accountability.
Confidential Client Contracts (Flow-Down Obligations)
Your client agreements often include obligations related to:
- Confidentiality
- Data handling
- Deliverable standards
Your outsourcing agreement must flow down these requirements. This ensures your vendor meets the same obligations you have committed to.
Export Controls + Data Location
Some projects involve restrictions on:
- Where data can be stored
- Who can access project files?
- Cross-border data transfer
If applicable, include clauses defining:
- Data residency
- Access limitations
- Compliance requirements
This is especially important for infrastructure or government work.
Payment Terms That Match AEC Delivery
Payment terms should align with how the AEC work is actually delivered. Misaligned payment structures often lead to disputes.
Pricing Models
Common pricing models include:
- Hourly billing
- Fixed fee
- Milestone-based payments
Choose based on scope clarity.
- Defined scope → fixed fee
- Ongoing support → hourly or retainer
Invoicing Triggers
Define when invoices are issued.
Examples:
- Upon delivery of the sheet set
- Upon approval of deliverables
- Monthly billing cycle
Tie invoices to accepted deliverables, not just effort.
Retainers, Rush Work, and Overtime Rules
Spell out:
- retainers and what they cover
- rush multipliers
- Overtime approval process (pre-approval required)
Governance, Communication, and Change Control
Even the best SOW template for AEC outsourcing fails without governance. You need clear roles and communication rules.
RACI (Who Does What)
Use a RACI matrix to define responsibilities:
- Responsible → Executes the work
- Accountable → Final decision maker
- Consulted → Provides input
- Informed → Updated on progress
Example:
- CAD production → vendor
- QA/QC → shared
- Final approval → client PM
Weekly Cadence + Escalation Path
Define communication structure:
- Weekly project meetings
- Daily coordination (if needed)
- Escalation contacts
Change Order Workflow
Changes are inevitable in AEC projects. Define how they are handled:
- Scope change request
- Impact on cost and timeline
- Approval process
Use formal change orders for clarity.
Termination + Transition (So You Can Switch Vendors Safely)
Exits are where many outsourcing agreements become risky. Plan the transition while things are calm.
Data Return, Deletion, and Certifications
When the contract ends:
- All project files must be returned
- Copies must be deleted
- Confirmation should be provided
Transition Assistance Period
Include a transition phase where the vendor:
- Supports handover
- Transfers knowledge
- Assists with onboarding a new team
This reduces disruption.
Locking Down Accounts and Shared Drives
Require:
- immediate access removal on termination
- confirmation that shared links are disabled
- audit trail export if needed
Why Work with a Specialized AEC Outsourcing Partner
Not all outsourcing partners understand AEC workflows. A generic vendor increases risk.
Industry-Specific Expertise
A specialized partner like Remote AE understands:
- BIM Execution Plans
- CAD standards
- QA/QC workflows
- Revit, AutoCAD, Navisworks, IFC workflows
This reduces onboarding time.
Pre-Trained Staff
Working with our trained professionals means:
- Faster production
- Fewer errors
- Less supervision
Proven Workflows
Established processes ensure:
- Clear deliverables
- Consistent quality
- Reliable communication
Reduced Risk
Remote AE assistants reduce:
- Rework
- Miscommunication
- Compliance issues
Why Remote AE
Remote AE provides dedicated virtual AEC assistants under structured contracts.
- Industry-Specific Expertise
- Guaranteed Quality & Reliability
- No Long-Term Commitment
- From 399$/week
There is no upfront cost. You can consult and evaluate before committing. If needed, you can replace up to two assistants within the first year.

Protect Your Projects with the Right AEC Outsourcing Contract!
An AEC outsourcing contract is not just a formality. It defines how work gets done, how risk is managed, and how quality is maintained. Poorly defined agreements lead to delays, rework, and disputes. Remote AE provides AEC-focused support with well-defined agreements, experienced professionals, and proven workflows. You stay in control of standards, approvals, and decisions. We handle the production.
Schedule a call today for a fast scope review and a clear weekly quote.
FAQs – AEC Outsourcing Contracts
What should an AEC outsourcing service agreement include?
An AEC outsourcing agreement should define the scope, deliverables, standards, and schedule. It should also cover roles, QA checks, SLAs, and change control. Include IP ownership, confidentiality, payment terms, and exit or handover conditions.
Who owns CAD drawings and BIM models created by an outsourced team?
In most cases, the client owns the deliverables after payment, if the contract states this clearly. The vendor usually retains pre-built tools such as templates or scripts. Ownership of native files and custom content should be clearly defined in writing.
Should I use an NDA before sending Revit or AutoCAD files to a contractor?
Yes, you should sign an NDA before sharing any files or access. It should limit the use of the files to your project only. It should also define rules for storage, sharing, and secure deletion.
What SLAs make sense for remote drafting and BIM production?
Useful SLAs include response time, turnaround time for updates, and on-time delivery targets. They should also define quality thresholds, acceptable error levels, and rework timelines. Include availability expectations and an escalation process.
Can an outsourced drafter or modeler stamp drawings?
In most cases, an outsourced drafter or modeler cannot stamp drawings. Stamping usually requires a locally licensed professional who takes responsible charge of the work. The outsourced team can support production, but the licensed professional must review and sign.
